The application was supported by an arboricultural assessment, an archaeological assessment, an ecological appraisal, a landscape scheme and a highways note and the conditions followed them. A non-material amendment in September 2024 removed the chimney and changed the external materials during the build.
The full story

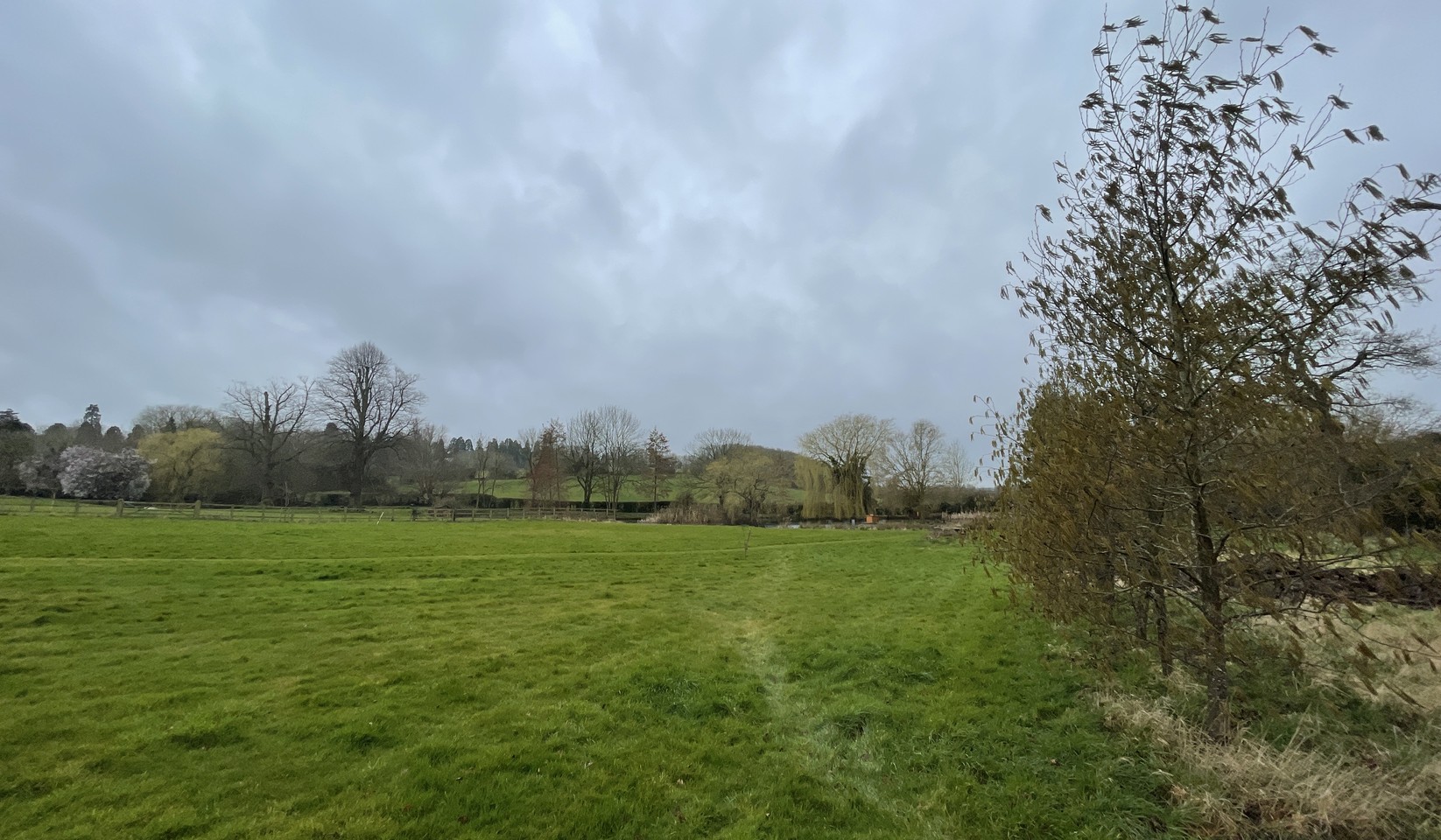

The plot sat inside the village boundary, so the principle of a house was arguable. Everything else counted against it: a greenfield site in a conservation area, a listed house to the south, three gardens above it to the east, a pond and a protected oak to the west. Our site appraisal and the council's pre-application advice turned each of those into a rule for the design. Keep out of the oak's root zone and the glazing away from the neighbours; keep the roof below their sightline and the field open. Hollow Meadow Farmhouse at Priors Hardwick, another new home in the district, is with our other Stratford-upon-Avon projects.
We asked the council for pre-application advice in June 2021. The reply that September supported a house here and the cluster of small roofs, asked for as many trees as possible to be kept and suggested a chimney as a nod to the village's own. The application answered it: the house stood clear of the oak's roots, with new native trees planned along the boundaries and a chimney on the kitchen. How we read a plot before the design starts is on our self-build architects page.

The house that came out of it is a cluster of small volumes rather than one block, each roof over a group of rooms, with the ridges at different heights the way the village's cottages and outbuildings are. The living rooms face the pond and the evening sun; the bedrooms sit on the north side. On the approach the windows are small and a window beside the front door looks straight through the house to the field behind.
It was designed to be lived in for a long time: one floor, a wet room en suite, doors wide enough for a wheelchair, a ramp to the garden. A ground source heat pump, insulation above the regulations, soakaways and rainwater collection were in the submission and an electric vehicle charging point became a condition.
The application went in during October 2021 with the tree, archaeology, ecology and landscape reports and was made valid on 15 November 2021. While the council considered it we added a further visual, revised the tree planting and the site plan and supplied a highways note. The amended plans were validated again on 11 March 2022 and permission was granted on 13 May 2022.
In a two-stage tender, six builders priced a first technical pack in early 2023 and the prices came back so far apart that the project paused for the market to settle. When it restarted at the end of 2023 we finished the technical design and a full specification, priced it with the preferred builder against a check price and worked through the provisional items before work started on site in June 2024.
The big glazed walls to the pond failed the simple check under the overheating rules introduced in 2022. Rather than cut that glazing by almost half, we had the house modelled in detail to CIBSE TM59 and it passed as designed. The ground investigation found stiff clay with a risk of heave near trees and the house went onto piles and ground beams with a suspended floor. The archaeological trenching the permission required found nothing of significance.
As built, the house is heated by an air source heat pump rather than the ground source pump in the application. On clay, soakaways were not practical: rainwater runs to the pond through an oversize pipe that holds back storm flows.
We provided the full RIBA service and administered the building contract, with practical completion certified in August 2025 and the final certificate in March 2026, after the defects period. During construction a non-material amendment removed the chimney and changed the external materials. The house was built in brick with composite panel cladding.
