The parish was writing a Neighbourhood Plan that would choose the sites, so the land had to win a place on it first. The community had real concerns about traffic on Marsh Road, about surface water and flooding, and about the scale of anything new. A weak, optimistic scheme would have collapsed at the first consultee response.
The full story
We treated the planning case as something to be built rather than asserted. Before any layout was drawn we commissioned and coordinated the evidence base: a topographical survey, ecology and arboricultural surveys, a Great Crested Newt survey, a flood risk and drainage strategy, and transport work. Every claim the application would go on to make had a specialist report behind it, which is what makes a case survive contact with consultees.

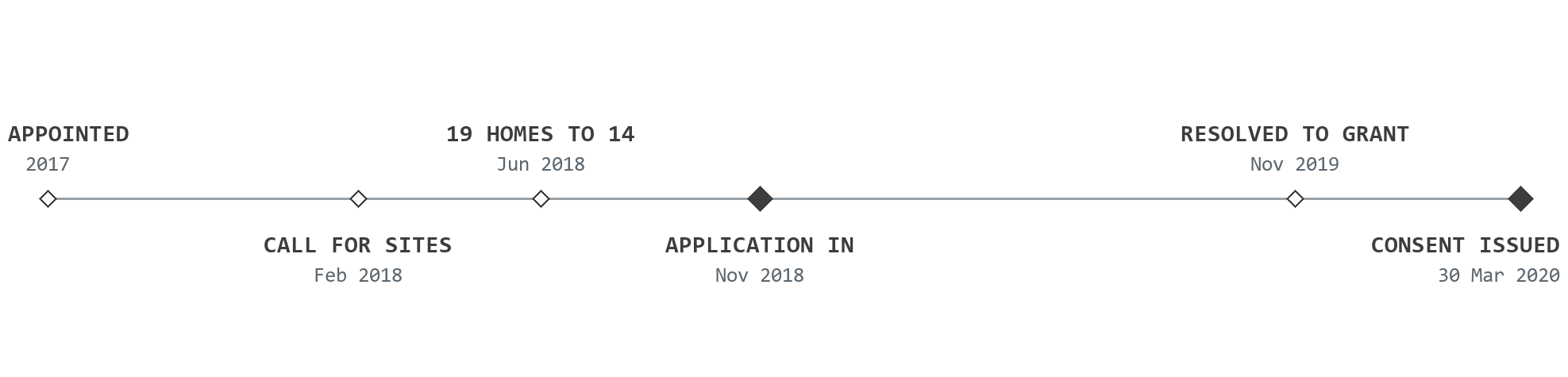

Then we promoted the land in the right order. The Call for Sites representation went to the Neighbourhood Plan working group in February 2018 and established the field as a credible housing site. In June a scheme for nineteen homes was presented at the public consultation the working group ran, and the response was clear: the community wanted less. Rather than argue, we cut the scheme to fourteen and commissioned further traffic and drainage work aimed squarely at the points that had been raised. The application that went in that November was five homes smaller and considerably harder to object to.

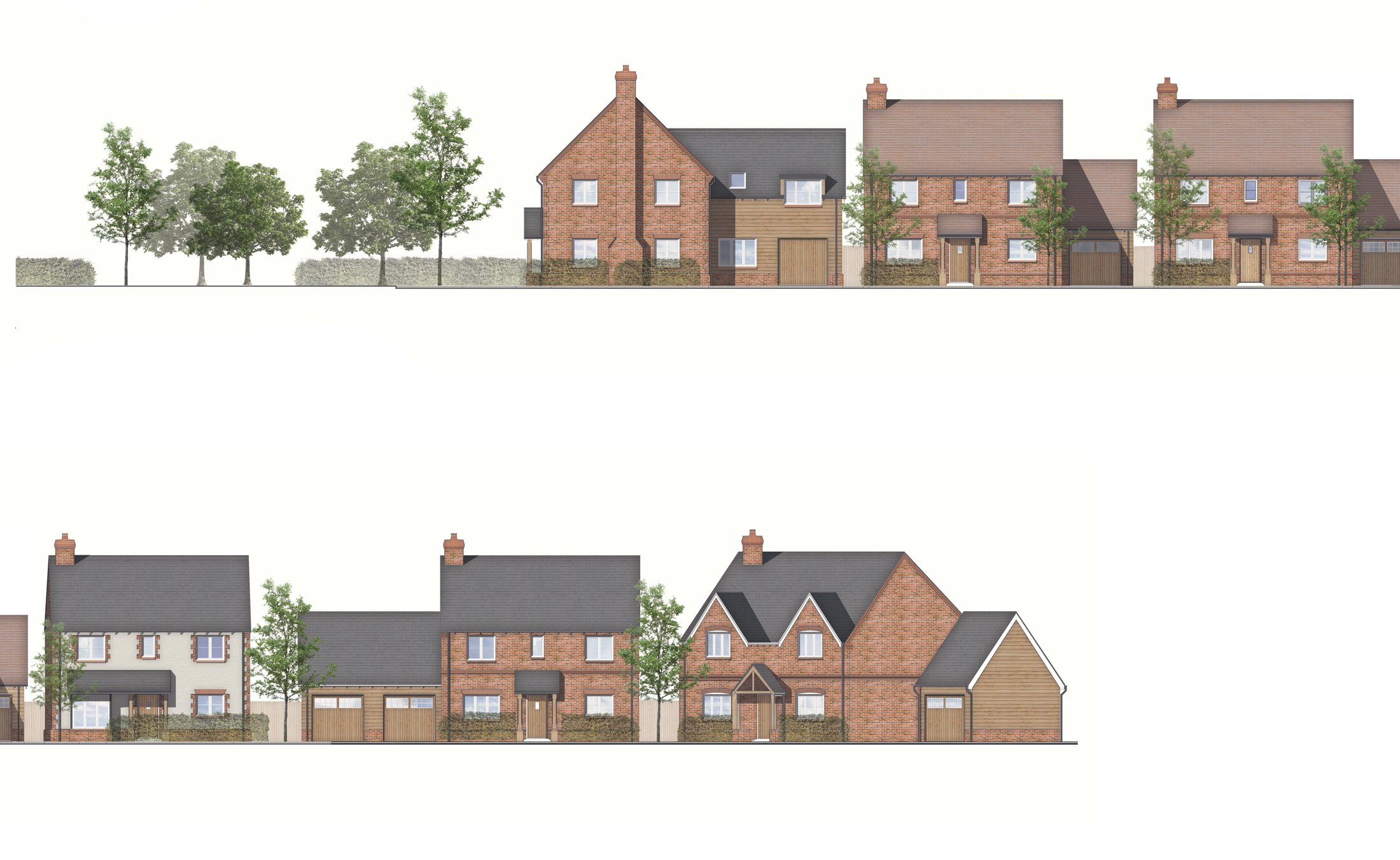

Design followed the constraints instead of fighting them. Dwellings sit back behind a retained and reinforced frontage hedgerow. The trees worth keeping along the western boundary are kept. The southern apex is left open so the village edge stays soft. And drainage was turned from a liability into an argument: rather than defend the run-off, the scheme caps it, at a rate the permission fixes at 1.1 litres per second, well below what an open field sheds in a storm.
We authored the Design and Access Statement and the Planning Statement, and managed the application through every consultee response to committee. Members resolved to grant on 13 November 2019 subject to a planning obligation, and once the Section 106 was signed the permission was issued on 30 March 2020. We refined the access through a variation in 2021. After that the consented, de-risked site was taken forward by the housebuilder Deanfield Homes, which secured the reserved matters approval and built the scheme out.
