Avonbury sits inside the land allocated for the North West Bicester eco-town, a zero-carbon development of six thousand homes. It sits outside that scheme's masterplan area. The first fact set the standards the building had to meet. The second is what made a standalone application possible at all.
How the policy was read
The masterplan point came first, and it was the one that mattered. Policy Bicester 1 states that permission will be granted at North West Bicester only in accordance with a comprehensive masterplan for the whole area. Read flatly, that is not a hurdle for a single infill office, it is a bar: no one is going to masterplan six thousand homes to add 557 square metres to a business park. Avonbury, though, lies outside the masterplan site area, and the council's pre-application report confirmed it. That is the distinction the application rested on, and without it there is no route at all.

What the exclusion did not do was lift the standards. The eco-town's substantive requirements still applied and still had to be answered: an energy statement, a low-carbon approach to construction, BREEAM Very Good as a minimum, and an economic strategy demonstrating employment reachable without a car. All three of the first group survive into the permission as conditions. The economic strategy was written around the tenants already on the park, four of them expanding and two at capacity, unable to find space of the right standard locally. The council's own report acknowledged that a full landscape and visual impact assessment would not be entirely proportionate for a building of this size, which is a fair summary of the whole exercise.

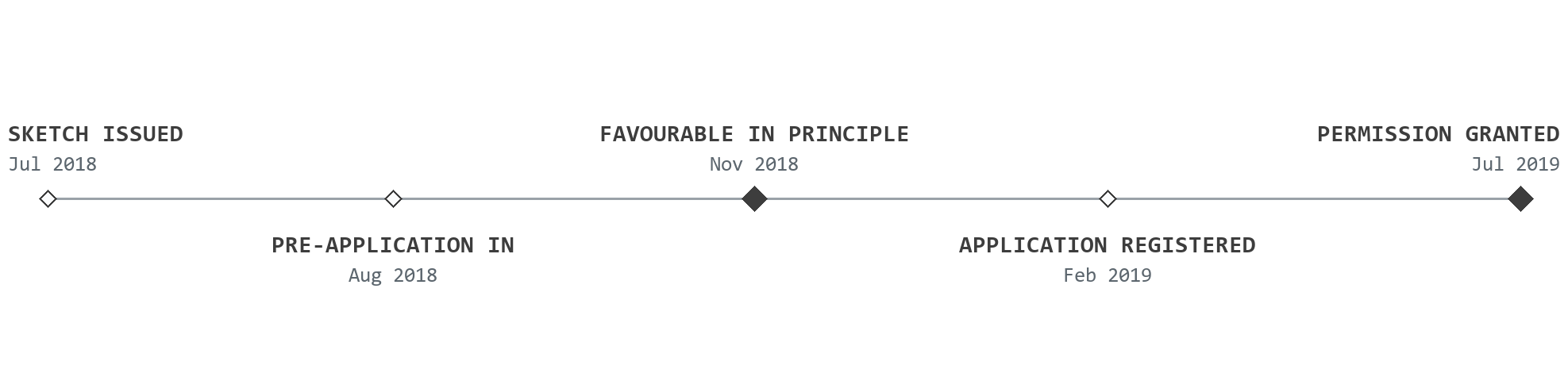

The sequencing is the transferable part. A pre-application submission is a fraction of the cost of a full one, and it was made before any consultant was appointed. It returned a favourable-in-principle view subject to two named tests, a highways position with the parking number attached, an ecology view that no full survey was needed, a drainage and water position, and a contaminated-land position. Only then were two reports commissioned, an ecological appraisal and a transport statement, because those were the two the council had actually asked for. On a constrained employment site the difference between a planning route and a planning gamble is usually just this: whether the principle was settled before the fees were spent.
